Big Horn Remodeling
Finished Las Vegas kitchen remodel with red wood cabinets, large island, and stone countertops

What Is Included in a Full Kitchen Remodel in Las Vegas?

A Las Vegas homeowner guide to full kitchen remodel scope, trades, sequencing, hidden systems, inclusions, exclusions, and estimate clarity.

Nathan Nehoraoff - Owner of Big Horn Remodeling, Nevada B-2 License #0091383

Nathan Nehoraoff

Owner & Licensed Nevada General Contractor

Published June 3, 202613 min readScope Resource

Short answer: What is included in a full kitchen remodel depends on the written scope, but most full projects include planning, demolition, cabinet removal, rough plumbing and electrical review, lighting, ventilation, drywall repair, flooring, cabinet installation, countertop templating, backsplash, finish fixtures, appliance coordination, inspections, cleanup, and punch-list completion.

A full kitchen remodel includes much more than new cabinets and countertops. In a real construction scope, the project may involve demolition, field measurements, layout planning, rough plumbing, electrical updates, lighting, ventilation, drywall, flooring, cabinet installation, countertop templating, backsplash, finish plumbing, appliance coordination, inspections, cleanup, and a final punch list.

For Las Vegas homeowners, the exact scope depends on the existing kitchen, the age of the home, whether the layout changes, whether plumbing or electrical work is being altered, and whether the project needs permit review. A cosmetic update may only replace visible finishes. A full kitchen remodel can involve multiple trades working in a specific sequence so the finished kitchen is safe, functional, code-aware, and built to last. For phase-by-phase scheduling, use the kitchen remodel timeline guide.

This guide explains what is typically included in a full kitchen remodel scope. If you are looking for pricing ranges, start with our kitchen remodel cost guide. If your project moves electrical, plumbing, gas, ventilation, walls, or openings, review our Las Vegas kitchen remodel permit guide before demolition.

Ready to turn this checklist into a buildable scope? See our Las Vegas kitchen remodeling services for field review, trade coordination, permit planning, and complete construction management.

A full kitchen remodel usually includes planning, demolition, cabinet removal, rough plumbing and electrical review, lighting, ventilation, drywall repairs, flooring, cabinet installation, countertop templating and installation, backsplash, finish fixtures, appliances, inspections where required, cleanup, and punch-list completion. Not every project includes every item, so the written scope matters.

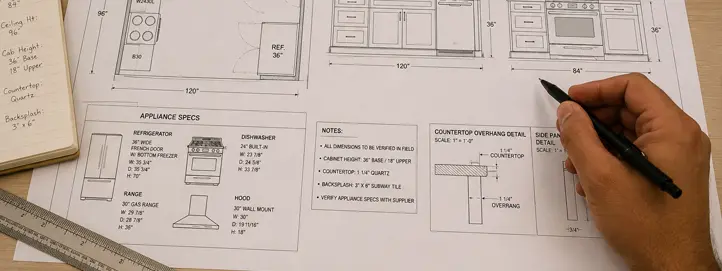

Kitchen remodel scope review meeting with cabinet layout appliance specs finish selections and written checklist
Kitchen remodel scope review showing cabinet layout, appliance specs, finish selections, and a written kitchen remodel checklist.

Printable Kitchen Remodel Checklist Summary

Use this compact checklist as a quick scope summary before comparing estimates. Each category should be marked as included, excluded, owner-provided, or pending selection in the written remodel scope.

Printable-style checklist

Confirm each category before comparing estimates.

  • Planning
  • Demo
  • Rough trades
  • Inspections
  • Drywall/floor prep
  • Cabinets
  • Countertops
  • Backsplash
  • Fixtures
  • Appliances
  • Final punch list

Included Vs Optional Kitchen Remodel Scope Items

A full kitchen remodel usually includes the main demolition, installation, finish, and closeout work. Larger layout, structural, appliance, flooring, slab, or HOA-related items should be separated because they often depend on the final project scope.

Typically included in a full remodel
Often optional / depends on scope
Demo
Wall removal
Cabinet removal
Structural engineering
Cabinet install
Major layout changes
Countertops
Flooring into adjacent rooms
Backsplash
Appliance purchase
Fixture installation
Custom cabinetry
Finish plumbing/electrical
Panel upgrades
Paint/touchups
Slab cutting
Cleanup
HOA submittals
Punch list

Full Kitchen Remodel Scope At A Glance

Phase
What It Includes
Why It Matters
Preconstruction
Site walkthrough, measurements, scope review, cabinet/appliance verification, finish selections, and permit review.
Locks the project direction before demolition and reduces change orders.
Demolition
Remove cabinets, counters, backsplash, flooring, drywall sections, soffits, or old fixtures as needed.
Reveals hidden conditions and prepares the kitchen for rough trades.
Rough trades
Plumbing, electrical, gas, mechanical/ventilation, framing, blocking, and inspection checkpoints when required.
These systems are hidden behind the finished kitchen and affect safety, function, and code compliance.
Surface prep
Drywall repair, wall flattening, floor prep, subfloor/slab review, backing, texture, and paint preparation.
Creates the foundation for clean cabinet, countertop, tile, and finish work.
Major installs
Cabinets, panels, fillers, trim, countertops, sink, faucet, flooring, backsplash, and appliance placement.
This is where design decisions become a functioning kitchen.
Finish and closeout
Electrical devices, plumbing trim, appliance hookups, caulking, adjustments, cleaning, punch list, and final walkthrough.
Confirms the kitchen works, looks complete, and is ready for daily use.

For pricing ranges connected to these scope categories, see the kitchen remodel cost guide. This page stays focused on what the written remodel scope should include.

How to use this checklist when comparing estimates

When two kitchen remodel bids are thousands of dollars apart, the difference is usually not just price. One estimate may include demolition, disposal, cabinet installation, plumbing tie-ins, electrical updates, drywall repairs, paint, appliance coordination, permit review, inspections, and final punch work. Another may only include visible finish installation.

Before choosing a contractor, ask each company to identify what is included, what is excluded, who supplies materials, who coordinates trades, whether permits are required, and what happens if hidden conditions are found after demolition.

Kitchen Remodel Scope Builder

Use this scope builder to understand what your remodel may include before you request an estimate. It is a planning summary, not a final scope or quote.

Likely remodel type

Based on the selections above.

Standard remodel

Likely included trades

planningscope reviewdemolitioncabinetscountertopsdrywallpaintflooringsurface prepbaseboardsappliance coordinationtilebacksplash

Permit questions to confirm

  • permit concern may be lower when work is truly finish-only and same-footprint

Questions before comparing estimates

  • What is included, excluded, or still pending selection?
  • Who coordinates cabinet, countertop, appliance, and trade sequencing?
  • Are cabinet boxes, panels, fillers, trim, hardware, and installation included?
  • Is flooring limited to the kitchen or continuing into adjacent rooms?
  • Who supplies, delivers, installs, connects, and verifies appliance clearances?
  • Is tile material, grout, trim, layout, and outlet coordination included?

Send this scope outline to Big Horn Remodeling for a project-specific review.

For detailed permit triggers, use the kitchen remodel permit guide; this scope builder is only a planning summary.

Cosmetic Kitchen Update Vs. Full Kitchen Remodel

A lot of confusion happens because homeowners use the word "remodel" for very different scopes. A cosmetic update may improve the look of the kitchen without changing the hidden systems. A full remodel can involve layout, trades, utility coordination, permit review, and a longer build sequence.

Category
Cosmetic Update
Full Kitchen Remodel
Cabinets
Paint, reface, replace doors, or install same-footprint cabinets.
New cabinet layout, panels, fillers, island, pantry storage, crown, hardware, and appliance clearances.
Countertops
Replace counters in same layout.
Coordinate cabinet installation, template, seams, sink/cooktop cutouts, overhangs, and support.
Plumbing
Often same sink and dishwasher locations.
May move sink, dishwasher, fridge water line, pot filler, disposal, or gas line.
Electrical
Limited fixture swaps.
May include new circuits, GFCI/AFCI review, island power, lighting layout, under-cabinet lighting, appliance circuits.
Walls / layout
Usually unchanged.
May include wall removal, framing changes, soffit removal, opening changes, or pantry rework.
Permit review
Often lower concern if truly finish-only.
Should be reviewed when hidden systems, walls, or regulated work are altered.
Best for
Refreshing a functional kitchen.
Rebuilding the kitchen around better layout, storage, code awareness, and long-term performance.

Scope clarity

Just replacing cabinets can become a full remodel if the new layout changes outlets, appliance locations, plumbing, ventilation, or wall conditions.

Phase 1 - Planning, Scope, And Field Verification

The most important part of a kitchen remodel often happens before demolition. A clean build starts with accurate measurements, a defined scope, and decisions that line up with the home's existing conditions.

  • Measure cabinet runs, ceiling heights, openings, windows, soffits, and appliance spaces.
  • Verify sink, dishwasher, refrigerator, range, microwave, and hood locations.
  • Review whether walls, soffits, plumbing, electrical, or gas lines may be affected.
  • Confirm finish selections and lead times for cabinets, countertops, appliances, fixtures, backsplash, and flooring.
  • Flag permit questions for jurisdiction review when the scope touches regulated work.
  • Plan the work sequence so cabinets, counters, appliances, and finish trades do not conflict.

This phase matters because kitchen decisions are connected. A refrigerator model can affect cabinet panel sizing. A range hood can affect ductwork. A sink relocation can affect plumbing. A new island can affect electrical, countertop support, aisle clearances, and flooring transitions. For the service-page overview, start with kitchen remodeling in Las Vegas.

Phase 2 - Demolition And Site Protection

Kitchen demolition may include removing cabinets, countertops, backsplash, flooring, drywall sections, soffits, lighting, appliances, sink, faucet, disposal, and trim. On a full remodel, demolition is not just removal. It is the point where the contractor learns what is behind the finished surfaces.

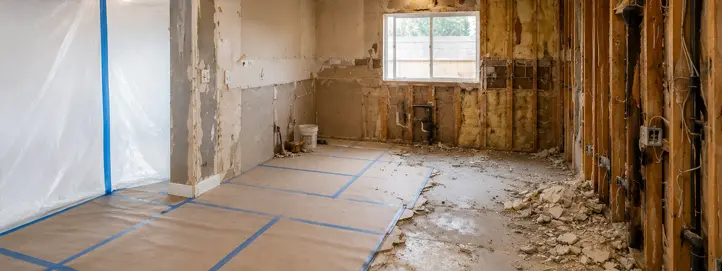

Kitchen remodel demolition with site protection and exposed hidden conditions before rough trades
Kitchen remodel demolition showing site protection, removed finishes, and exposed hidden conditions before rough trades begin.
  • Protect adjacent rooms, flooring paths, and dust-sensitive areas.
  • Disconnect or coordinate shutoffs for water, electrical, gas, and appliances as needed.
  • Remove existing finishes carefully enough to expose hidden conditions.
  • Identify damage, unpermitted prior work, poor wiring, old plumbing, slab issues, or framing problems.
  • Dispose of construction debris properly and keep the site workable for the next trades.

A good demolition phase helps prevent surprises from being ignored. If hidden issues are discovered, they should be documented, explained, and handled through a clear change-order process when they are outside the original scope.

Phase 3 - Rough Plumbing, Gas, Electrical, And Mechanical Work

The rough-in phase is where many of the most important kitchen decisions happen. This work is often hidden after drywall, cabinets, and backsplash are installed, which is why it needs to be planned correctly.

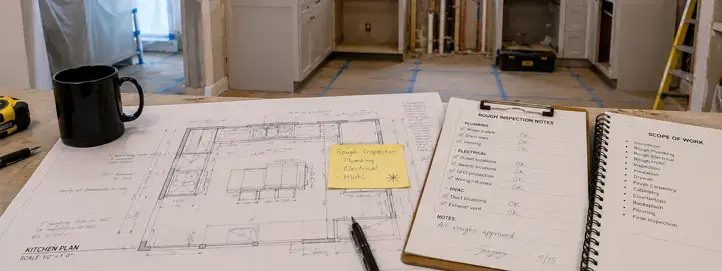

Kitchen remodel plans inspection notes and trade scope documents for rough plumbing electrical gas and ventilation
Rough-trade planning documents for plumbing, electrical, gas, and ventilation scope.
Trade
Common Kitchen Scope Items
Common Mistakes To Avoid
Plumbing
Sink relocation, dishwasher connection, disposal, fridge water line, pot filler, drain and vent review.
Moving fixtures without confirming drain slope, venting, access, shutoffs, or slab impact.
Gas
Gas range or cooktop relocation, shutoff placement, appliance connection requirements.
Assuming a gas line can move cheaply without route, capacity, or inspection review.
Electrical
Dedicated appliance circuits, GFCI/AFCI protection review, island outlets, lighting, switches, disposal, microwave, under-cabinet lighting.
Planning cabinets before outlet and appliance requirements are verified.
Mechanical / ventilation
Range hood, duct routing, makeup-air consideration when applicable, exhaust termination, HVAC register conflicts.
Choosing a hood after cabinets are ordered or assuming recirculating ventilation is always enough.
Framing / blocking
Wall changes, soffit removal, island backing, cabinet blocking, support for heavy fixtures or panels.
Installing finishes without proper backing, alignment, or wall correction.

For permit triggers connected to rough trades and hidden systems, review the kitchen remodel permit guide. This section only identifies the rough-trade scope that should be coordinated.

Phase 4 - Drywall, Floor Prep, And Surface Preparation

After rough trades, the kitchen needs to be put back together before finishes can be installed. Surface preparation can include drywall patching, texture matching, wall straightening, floor prep, slab review, subfloor correction, and paint preparation.

This stage affects the final look more than many homeowners expect. Cabinets need reasonably straight walls. Countertops need level and secure cabinets. Backsplash needs a clean substrate. Flooring transitions need to be planned before final pieces are installed.

Phase 5 - Cabinets, Panels, Fillers, And Storage

Cabinets are usually the backbone of a full kitchen remodel. They determine storage, appliance fit, countertop measurements, backsplash edges, lighting placement, and the final look of the room.

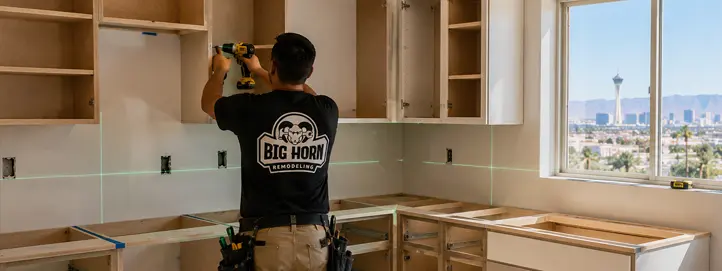

Kitchen remodeling crew installing cabinets before countertop template and finish work
Cabinet installation showing cabinets set before countertop template, lighting alignment, and finish details.
  • Base cabinets, wall cabinets, pantry cabinets, island cabinets, and specialty storage.
  • Fillers, finished panels, end panels, toe kicks, crown, light rail, valances, and cabinet trim.
  • Hardware placement, soft-close hinges, drawer boxes, pullouts, trash pullouts, and organizers.
  • Appliance openings for refrigerator, range, microwave, dishwasher, oven, and hood.
  • Leveling, fastening, alignment, reveal consistency, door/drawer adjustments, and final touch-ups.

A cabinet layout should not be treated like furniture placement. It must coordinate with appliances, utilities, clearances, countertops, lighting, and daily kitchen workflow.

Phase 6 - Countertops, Sink, And Template Coordination

Countertops cannot be accurately fabricated until cabinets are installed and field conditions are confirmed. The template process verifies measurements, seams, overhangs, sink cutouts, cooktop cutouts, and support requirements.

Countertop Decision
Why It Matters
Material
Quartz, granite, quartzite, porcelain slab, butcher block, and other materials vary in maintenance, durability, weight, and fabrication needs.
Seam placement
Poor seam planning can make a high-end counter look cheap or create weak points in busy areas.
Overhangs
Large island seating overhangs may need brackets, panels, or hidden support.
Sink type
Undermount, workstation, farmhouse, and integrated sinks affect cabinet, plumbing, and template details.
Cooktop / range
Cutouts, clearances, power/gas, ventilation, and manufacturer specifications must be coordinated.

Phase 7 - Backsplash, Tile, Lighting, And Finish Details

The finish phase is where the kitchen starts to look complete, but it still requires coordination. Backsplash layout must account for outlets, edges, windows, appliance clearances, hood height, and countertop lines. Lighting must align with both function and design.

  • Backsplash tile, grout, trim edges, niche or shelf details where applicable.
  • Under-cabinet lighting, recessed lighting, pendants, switches, dimmers, and device plates.
  • Finish plumbing for sink, faucet, disposal, dishwasher, and refrigerator water line.
  • Appliance placement, leveling, connection coordination, and manufacturer clearance checks.
  • Paint touch-ups, caulking, trim, baseboards, thresholds, and final adjustments.

What A Kitchen Remodel Estimate Should Clearly Include

A useful kitchen remodel estimate should make the scope understandable. It should not be a vague one-line number that leaves homeowners guessing what is included.

Kitchen remodel estimate review with blueprint scope categories exclusions and written checklist
Kitchen remodel estimate review showing blueprint, scope categories, exclusions, and checklist items.
Scope Category
Should Be Clear In The Estimate
Demolition
What is being removed, what is protected, and whether debris disposal is included.
Cabinets
Cabinet grade, layout, installation, trim, hardware, panels, fillers, and whether cabinets are supplied by the contractor or owner.
Countertops
Material allowance or selected material, templating, fabrication, installation, sink/cooktop cutouts, and edge profile.
Plumbing
Which fixtures move, what stays, which valves/lines/drains are included, and whether finish hookups are included.
Electrical
Lighting, outlets, switches, circuits, appliance feeds, under-cabinet lights, and device trim.
Appliances
Whether appliances are supplied, installed, connected, or only coordinated.
Flooring
Kitchen only vs adjacent areas, transitions, baseboards, floor prep, and disposal.
Backsplash
Tile material, labor, grout, trim, layout, and outlet coordination.
Permits / inspections
Whether the scope includes permit coordination when required.
Exclusions
Items not included, allowances not finalized, owner-provided materials, and conditions that could trigger change orders.

Scope also controls schedule. If you are trying to understand sequencing, see the kitchen remodel timeline guide.

Estimate Clarity: Language Homeowners Should Expect

When you are comparing kitchen remodel bids, look for written scope language that is specific enough to compare line by line. The estimate does not need to read like a legal document, but it should make the included work, exclusions, owner-provided items, and change-order process clear before demolition starts.

Scope Area
Exact Language To Expect
Demolition
Demolition includes removal of existing kitchen cabinets, countertops, backsplash, selected flooring, appliance disconnect coordination, debris haul-off, and basic site protection for adjacent work areas.
Cabinets
Cabinet scope includes cabinet boxes, doors, drawer fronts, panels, fillers, toe kicks, trim, hardware installation, leveling, fastening, and final door and drawer adjustment.
Countertops
Countertop scope includes field template after cabinet installation, fabrication, delivery, installation, sink or cooktop cutouts, seam planning, and standard edge detail unless upgraded in writing.
Plumbing
Plumbing scope identifies whether the sink, dishwasher, disposal, refrigerator water line, pot filler, drain, vent, or gas appliance locations stay in place or move.
Electrical
Electrical scope identifies lighting, switches, outlets, island power, appliance circuits, under-cabinet lighting, device trim, and what remains unchanged.
Owner-provided items
Owner-provided appliances, fixtures, tile, lighting, or hardware must be listed with delivery timing, compatibility responsibility, and installation responsibility.
Exclusions
Exclusions are listed separately and may include structural engineering, panel upgrades, remediation, work outside the kitchen footprint, HOA submittals, or hidden conditions.
Change orders
Work outside the written scope requires a written change order describing the added work, schedule impact, and cost impact before the work proceeds.

If the written scope is clear but you still need budget ranges or allowance context, use the kitchen remodel cost guide. This page should help you understand what the estimate says; the cost guide should help you understand what those scope choices can do to the budget.

What May Not Be Included Unless It Is Written Into The Scope

Some items are commonly assumed by homeowners but may not be included in every kitchen remodel estimate. These should be clarified before signing.

  • Appliance purchase or upgraded appliance package.
  • Structural engineering for wall removal or beam installation.
  • Major electrical panel upgrades or service changes.
  • Gas line relocation or gas appliance conversion.
  • Flooring outside the kitchen footprint.
  • Asbestos, lead, mold, pest, or water-damage remediation.
  • HOA architectural submittals or design review packages.
  • Custom cabinet accessories beyond the base package.
  • Specialty lighting, smart switches, or low-voltage work.
  • Temporary kitchen setup, storage, or moving services.
  • Drywall/paint work beyond kitchen remodel impact areas.
  • Unexpected conditions behind walls, under floors, or in the slab.

Why Kitchen Remodel Bids Can Look So Different

Two contractors may both say they are bidding a "full kitchen remodel," but the scopes may be completely different. One estimate may define rough trades, cabinets, countertops, backsplash, paint, appliances, and closeout. Another may only name the visible finishes and leave important scope items undefined.

Low-Detail Scope Warning Sign
Why It Matters
Kitchen remodel - labor and materials with no trade breakdown.
You cannot tell whether plumbing, electrical, backsplash, flooring, paint, or appliances are included.
Undefined allowances or selections.
The scope is not clear enough to compare against another estimate.
No appliance specification review.
Cabinet openings, circuits, ventilation, and clearances may be wrong.
No permit coordination language.
Use the permit guide to confirm whether the scope should be reviewed before work starts.
No change-order process.
Unexpected conditions can become disputes instead of documented decisions.
No schedule or sequencing explanation.
Cabinet, countertop, and trade handoffs are harder to manage.

For budget impact and pricing ranges, use the kitchen remodel cost guide. For permit-specific questions, use the kitchen remodel permit guide.

Need a written scope before comparing bids?

Big Horn Remodeling can review your kitchen, clarify what should be included, and help you compare estimates against the same construction scope.

Call or text

(702) 799-9902

Las Vegas-Specific Kitchen Remodel Scope Considerations

Las Vegas and Clark County homes can have different kitchen remodel issues depending on age, neighborhood, prior renovations, slab conditions, HOA requirements, and jurisdiction. A strong local scope should account for these conditions before construction starts.

  • Slab-on-grade homes can make drain relocation and island plumbing more involved.
  • Older remodels may hide unpermitted electrical, plumbing, or ventilation work.
  • Master-planned communities such as Summerlin, Green Valley, Southern Highlands, and Skye Canyon may have HOA rules for work hours, exterior changes, trash bins, parking, and approvals.
  • Jurisdiction should be confirmed early when the scope touches regulated work.
  • Appliance and cabinet lead times can affect schedule, especially when custom panels, luxury appliances, or specialty finishes are selected.
  • Hot weather, occupied-home logistics, dust control, and daily kitchen access should be planned before demolition.

Kitchen Remodel Scope Checklist

Use this checklist before comparing kitchen remodel estimates. A contractor does not need to include every item below, but the estimate should make clear what is included, excluded, or pending selection.

Category
Questions To Confirm
Layout
Are walls, doors, windows, pantry areas, soffits, appliance locations, island layout, or cabinet runs changing?
Demolition
What is being removed? Is haul-off, protection, and cleanup included?
Cabinets
Are cabinet boxes, doors, panels, fillers, trim, hardware, and installation included?
Countertops
Is material, templating, fabrication, sink cutout, cooktop cutout, delivery, and install included?
Plumbing
Are sink, dishwasher, disposal, pot filler, fridge water line, gas line, or drains moving?
Electrical
Are outlets, switches, lighting, appliance circuits, GFCI/AFCI protection, island power, and under-cabinet lighting addressed?
Ventilation
Is the hood ducted or recirculating? Are duct route and termination confirmed?
Flooring
Is flooring limited to the kitchen or continuing into adjacent rooms? Are transitions and baseboards included?
Backsplash
What tile, trim, grout, layout, and outlet coordination are included?
Permits
Who confirms whether permit coordination belongs in the scope?
Closeout
Is cleanup, punch list, final walkthrough, and warranty process included?

Want To Know What Your Kitchen Remodel Should Include?

Every kitchen remodel has a different scope. Some projects are cosmetic updates. Others require plumbing, electrical, ventilation, cabinet redesign, flooring, tile, permit coordination, and multiple trade handoffs. Big Horn Remodeling can review your kitchen, discuss your goals, and help clarify what should be included before you compare estimates.

REALPROJECTPHOTO
Completed kitchen remodel after clear scope planning sequencing inspections and final punch list
Completed kitchen remodel showing the result of clear scope planning, sequencing, inspections, and final punch-list work.

Call or text Big Horn Remodeling at (702) 799-9902 or request a free consultation. We will help you separate cosmetic updates from full construction scope so you can make a confident decision.

Use Scope Builder

Frequently Asked Questions

What is usually included in a full kitchen remodel?
A full kitchen remodel usually includes planning, demolition, cabinet removal, rough plumbing and electrical review, lighting, ventilation, drywall repairs, flooring, cabinet installation, countertop templating and installation, backsplash, finish fixtures, appliances, inspections where required, cleanup, and punch-list completion.
Are appliances included in a kitchen remodel?
Sometimes. Appliances may be supplied by the homeowner or included through the contractor. The estimate should clearly state whether appliance purchase, delivery, installation, connection, and manufacturer-specific clearance coordination are included.
Is backsplash included in a kitchen remodel?
Backsplash is commonly included in a full kitchen remodel, but it should still be listed in the written scope. The scope should specify tile material, layout, grout, trim pieces, outlet coordination, and whether full-height backsplash is included.
Is flooring included in a kitchen remodel?
Flooring may be included, but it depends on the project. Some kitchen remodels keep existing flooring. Others replace flooring in the kitchen only or continue flooring into adjacent rooms for a cleaner transition.
Does a full kitchen remodel require permits in Las Vegas?
Permit requirements depend on scope and jurisdiction. If the project changes electrical, plumbing, gas, mechanical, walls, framing, openings, or other regulated systems, permit review is usually appropriate before demolition starts.
What is not usually included in a kitchen remodel estimate?
Common exclusions can include appliance purchases, engineering, major panel upgrades, hidden damage, remediation, HOA submittals, owner-provided materials, specialty upgrades, or work outside the kitchen unless written into the scope.
Does a full kitchen remodel include cabinet installation?
Yes, most full kitchen remodels include cabinet removal and new cabinet installation, but the estimate should specify cabinet supply, delivery, assembly, fillers, panels, trim, hardware, and any modifications required for appliances or walls.
Who coordinates the trades during a full kitchen remodel?
A licensed general contractor should coordinate demolition, plumbing, electrical, mechanical, drywall, cabinets, countertops, tile, paint, inspections, and finish work so the trades do not conflict or bury required work before it is checked.
Can I compare two kitchen remodel estimates by total price alone?
No. Compare the written scope, materials, exclusions, permit responsibilities, inspection coordination, allowances, appliance assumptions, cabinet grade, countertop material, and change-order terms before comparing the final number.
Luxury kitchen with dark island cabinets, white upper cabinets, black faucet, slab backsplash, range hood, and pendant lighting

Luxury Kitchen Remodel

Luxury Kitchen Remodel in Las Vegas

Plan a luxury kitchen remodel in Las Vegas with custom cabinets, premium countertops, oversized islands, appliance integration, lighting, ventilation, and build-ready scope decisions.

Published June 9, 2026

Read Guide

Contact Us

TODAY!

Nathan Nehoraoff - Owner of Big Horn Remodeling, Nevada B-2 License #0091383

About the author

Nathan Nehoraoff is the owner of Big Horn Remodeling, a licensed Nevada B-2 General Building contractor based in Las Vegas. Big Horn specializes in kitchen, bath, permit coordination, and whole-home remodeling across Henderson, Summerlin, and the greater Las Vegas valley. Nevada license #0091383 is used consistently across Big Horn's author, footer, homepage, and service-page references.

Every kitchen remodel has a different scope. Big Horn Remodeling can review your kitchen, discuss your goals, and help clarify what should be included before you compare estimates. Get a free in-home estimate:
