Dulce Donuts: Resolving a Prior Owner's Unpermitted Restroom Demolition

Big Horn Remodeling documented a prior owner's completed restroom removal, coordinated City of Las Vegas and fire inspections, and delivered the occupancy certificate to the violation handler to close the case. The cover image illustrates the permit process; it does not show the Dulce Donuts project site.

Location

Las Vegas, NV 89108

Investment

Approx. $7,000

Timeline

Not recorded

Permits

C24-01976 completed

Client Goal

Resolve the inherited violation for a prior owner's unpermitted restroom removal while retaining the usable storage arrangement.

Finished Result

City and fire approvals, a Certificate of Occupancy, and violation case closure after Big Horn sent the certificate to the violation handler.

The certificate still had to reach the violation officer

The City of Las Vegas issued a Certificate of Occupancy under building permit C24-01976. The permit record was completed, with key number 1915576. That provided the occupancy documentation for the approved tenant-improvement assignment.

There was one more communication to complete. Big Horn emailed the certificate to the individual handling the violation, who then closed the case. That handoff connected the permitting outcome to the enforcement matter the owner had originally hired us to resolve.

The certificate and the case closure are related but distinct parts of the project record. The certificate identifies the permit and property; the closure followed our communication with the violation handler.

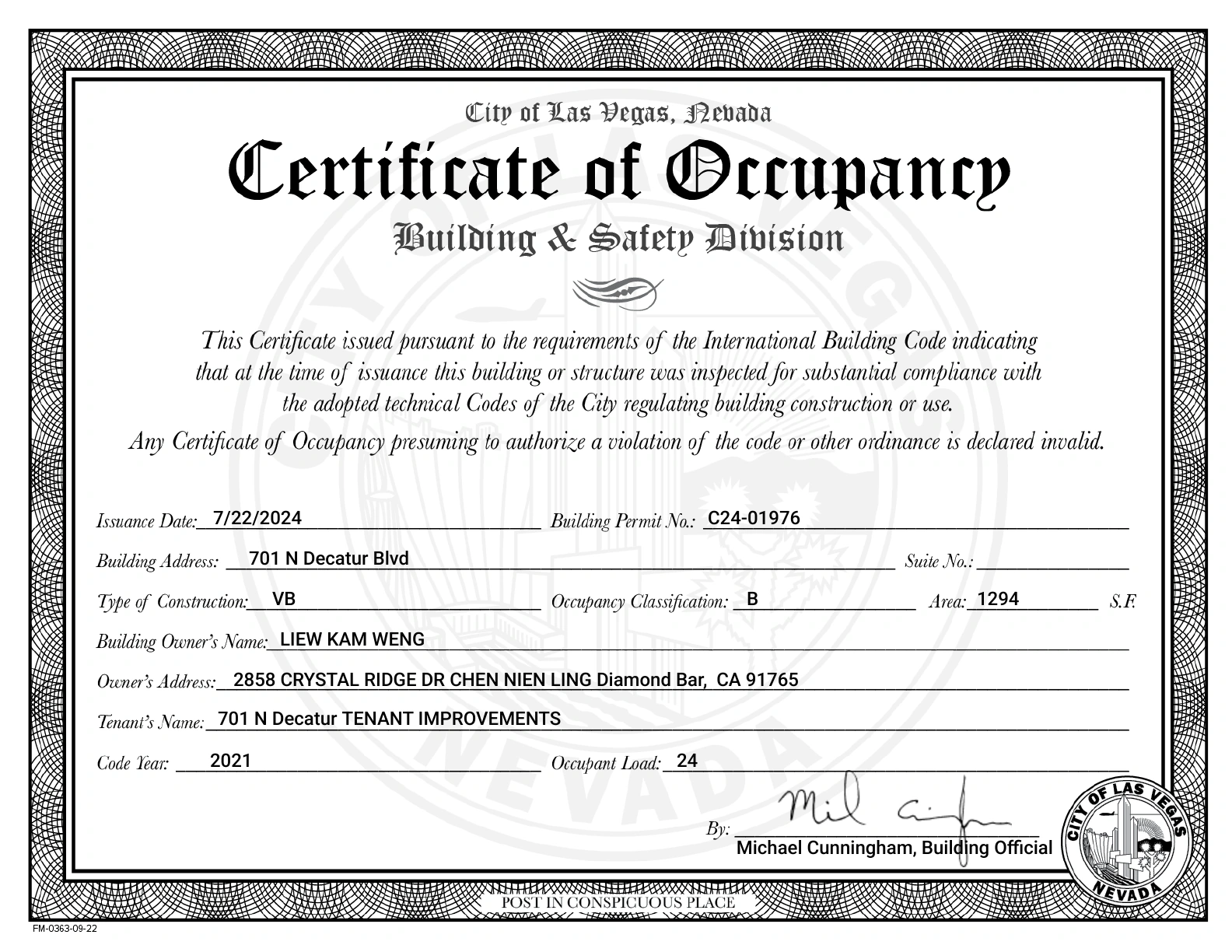

City of Las Vegas Certificate of Occupancy for permit C24-01976 at 701 N Decatur Blvd.
Look for the property address and permit C24-01976. These identify the occupancy document for this assignment. The violation handler closed the case after Big Horn emailed the certificate.

Download this project's Certificate of Occupancy (PDF)

View the original City of Las Vegas Certificate of Occupancy for permit C24-01976, exactly as supplied.

Project information provided by Nathan Nehoraoff, owner of Big Horn Remodeling (Nevada B-2 license #0091383). Based on his firsthand account and the supplied City of Las Vegas Certificate of Occupancy.

Dulce Donuts' new owner had bought an operating business and inherited a problem hidden in its construction history. A previous owner had removed a toilet, sink, and several non-load-bearing restroom walls to gain storage space at 701 N Decatur Blvd, Las Vegas, NV 89108. The work had been completed without permits.

The shop continued operating, but the City of Las Vegas had issued a violation, and the owner was facing $200 in weekly fines. Leaving the case unresolved meant continued expense and the possibility of further enforcement. The owner had also struggled to find a general contractor who could handle approval of work that was already finished.

Big Horn Remodeling was hired to investigate the existing conditions, document the completed alteration, and carry it through the City's approval process. Our assignment began after the demolition; we did not remove the restroom. The owner's goal was to resolve the violation and keep the usable storage arrangement.

A removed restroom, with another restroom still in place

The removed fixtures were not the shop's only restroom facilities. Another restroom remained, and the City accepted the arrangement during this project's review. The approval concerned this particular layout, including the restroom that remained.

Our review also addressed the walls removed during the earlier work. They were non-load-bearing partitions, rather than structural walls supporting the building. Establishing what had actually changed gave the submission a defined scope: a former restroom area used for storage, with its toilet, sink, and partitions already removed.

This was not a new restroom installation or an accessibility renovation. Nor does the result establish that another food business can remove a restroom on the same basis. The remaining facilities and the City's acceptance were specific to Dulce Donuts.

Visible plumbing caps made the existing work inspectable

When our team visited, the plumbing caps associated with the removed fixtures were visible. We could inspect the terminations directly instead of relying only on an owner's description of what had been done. That access was useful because the fixtures were gone, but their former connections still needed to be accounted for.

The electrical outlets had stayed in place. They had not been demolished along with the restroom fixtures and walls. Our scope therefore involved reviewing retained electrical conditions, not replacing the outlets.

No corrective construction was needed in this case. Our work focused on investigating and documenting the existing alteration, then coordinating its approval. That finding came from this site's conditions; it was not an assumption that previously completed work would always be accepted without repairs.

Showing completed demolition in an existing-and-proposed plan format

Big Horn prepared the plan package using an existing-and-proposed format. Although that terminology is often associated with work that has yet to happen, the City was aware that the restroom demolition had already occurred. The submission sought approval of the as-built condition.

The important distinction was between the drawing format and the status of the work. Using an existing-and-proposed presentation did not mean we represented the earlier demolition as a future project. It provided a familiar way to communicate the alteration and the arrangement being submitted for acceptance.

For this assignment, the drawings and the site investigation served different purposes. The drawings communicated the layout change for review; the field visit established the visible conditions behind that description. Both were needed to explain the completed work. For the broader drawing service, see our permit drawings and plan-set preparation page. For the broader documentation service, see our as-built plans and existing-condition drawings guide.

Building and fire inspections addressed the actual alteration

After the plan submission, the project proceeded through City and fire inspections. The review focused on life-safety concerns, including the electrical conditions and verification that the removed walls were not load-bearing. Big Horn coordinated the inspections and met with the inspector as part of the assignment.

Both inspections were approved. The submitted scope concerned the completed restroom removal and retained building conditions, rather than a newly constructed bathroom awaiting inspection.

The practical value for the owner was having a contractor carry the work beyond the drawing stage. Preparing a plan set was one part of the job; bringing the documented alteration through the required field approvals was another.

What the $7,000 assignment covered

The completed project price was $7,000. It included the plan work, all permit fees, and meeting the inspector, with Big Horn coordinating the process through approval and the violation-closeout communication. No corrective construction was required.

This was the price of resolving this existing-work assignment, not the cost of building a new bathroom or a municipal permit fee by itself. The owner's $200 weekly fines were the separate enforcement issue motivating the project; they should not be confused with the quoted service price.

The owner retained the storage arrangement, obtained the occupancy documentation, and had the violation case closed. For a business that had continued operating throughout the issue, the result was a resolved construction record and relief from an open enforcement problem.

Dulce Donuts on North Decatur Boulevard

This map shows the public commercial project address.

Have you inherited unpermitted work at a business?

Send Big Horn Remodeling the violation notice, property address, and photos of the affected area. Our retroactive permit services cover reviewing existing work and coordinating the applicable approval path. Dulce Donuts shows one completed outcome; the necessary corrections and approvals depend on the conditions at each property.

Permit Services

Questions about the project record

Why does the certificate list 1,294 square feet?
That is the premises area recorded on the certificate, not the area of the demolished restroom. The assignment concerned an alteration within the existing shop. The document's area field should not be used to describe the size of the demolition or to calculate a construction price per square foot for this project.
Why does the certificate use the description "701 N Decatur TENANT IMPROVEMENTS"?
That is the wording in the certificate's tenant-name field. It does not use the Dulce Donuts trade name or itemize the removed fixtures. The property address and permit number connect the document to this assignment; the business name and detailed work description come from Big Horn's firsthand project account. The wording does not mean Big Horn completed a full-shop renovation.
Does the certificate itself say the violation case was closed?
No. It documents the City's occupancy approval under permit C24-01976. Big Horn's project account supplies the next step: the certificate was emailed to the individual handling the violation, who closed the case. Keeping those records distinct makes the outcome clear without attributing an enforcement-closure statement to a document that does not contain one.

Contact Us Today!

Nathan Nehoraoff - Owner of Big Horn Remodeling, Nevada B-2 License #0091383
online

Ask for Nathan

Business Hours
  • Mon-Fri: 7:00 AM - 7:00 PM
  • Sat: 8:00 AM - 7:00 PM
  • Sun: 8:00 AM - 6:00 PM

You can still text outside business hours and receive a prompt reply

Contact Channels

Choose your preferred channel for project questions, photos, scope notes, scheduling, and faster day-to-day communication updates.
