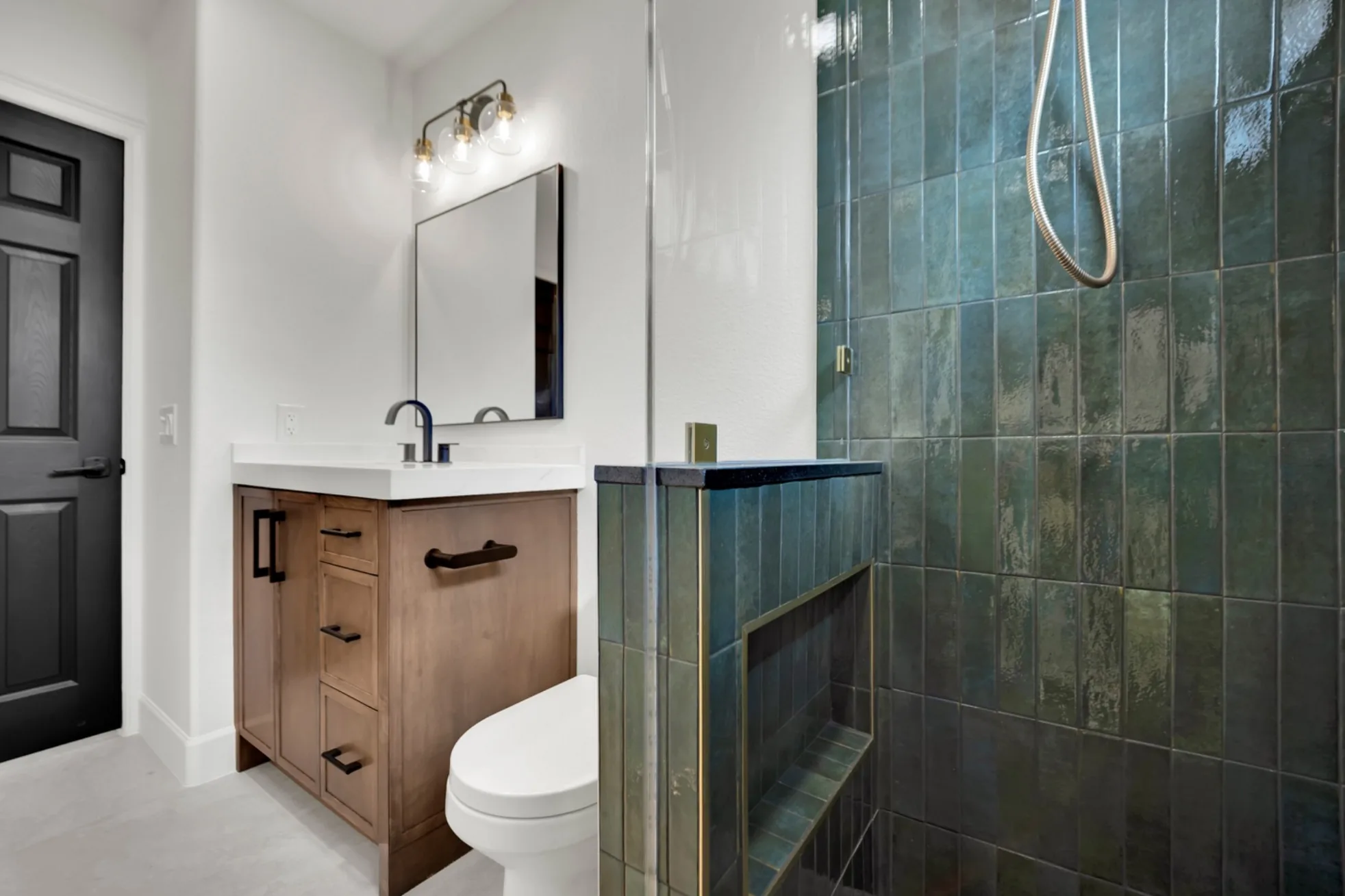

Big Horn Remodeling
Finished secondary bathroom with walk-in shower, custom glass, Moroccan-style ceramic tile, custom wood vanity, quartz countertop, and large-format floor tile

Tub-to-Shower Conversion With Moroccan-Style Tile and Custom Vanity

A completed secondary bathroom case study where Big Horn Remodeling removed a builder-grade fiberglass tub/shower insert, mitigated moisture-damaged drywall, upgraded the shower drain, relocated the valve, waterproofed the shower, completed a 24-hour water test, and finished the room with Moroccan-style ceramic tile, custom glass, a custom vanity, and quartz.

Project Type

Tub-To-Shower

Investment

Approx. $18,000

Timeline

Approx. 3 weeks

Permits

Electrical and plumbing

Client Goal

Replace a dated fiberglass tub/shower insert with a walk-in shower and make the secondary bathroom feel clean, cohesive, and custom.

Finished Result

A permitted walk-in shower with Moroccan-style tile, pony wall, hidden niche, custom glass, custom vanity, quartz top, large-format floor tile, and water-tested waterproofing.

Finished secondary bathroom with walk-in shower, custom glass, Moroccan-style ceramic tile, custom wood vanity, quartz countertop, and large-format floor tile
Finished secondary bathroom with walk-in shower, custom glass, Moroccan-style ceramic tile, custom wood vanity, quartz countertop, and large-format floor tile.

Photo 1 of 3

Completed Tub-To-Shower Conversion Case Study

Big Horn Remodeling completed this tub-to-shower conversion and full secondary bathroom remodel in the Tule Springs / Centennial Hills area of Northwest Las Vegas. The original bathroom was an outdated builder-grade fiberglass tub/shower insert with an older Delta valve, dated finishes, and moisture damage at the drywall from a failed seal.

The homeowners wanted the bathroom to feel clean, intentional, and beautiful - not like a basic replacement shower. The finished space now has a walk-in shower with custom glass, glossy Moroccan-style 3x6 ceramic wall tile, a waterproofed pony wall, a hidden shampoo niche, a relocated Kohler shower valve, a custom vanity with quartz countertop, large-format floor tile, and semi-gloss bathroom paint for a more durable wet-area finish.

This page is a completed project case study. For broader service information, use the main bathroom remodeling in Las Vegas page. For broader local planning in Northwest Las Vegas, use the Centennial Hills remodeling contractor page.

Client Goal: A Secondary Bathroom That Looked Intentional

The homeowners were not looking for a simple insert replacement. They wanted the secondary bathroom to feel updated, cohesive, and beautiful. The design needed to flow with the rest of the home while still solving practical issues in the original bathroom: an outdated fiberglass tub/shower combo, an old valve location, moisture-damaged drywall, limited visual character, and builder-grade finishes.

A major usability goal was the shower valve location. The client wanted the valve on the opposite side so the shower could be turned on and warmed up before stepping into the water stream.

Finished secondary bathroom with walk-in shower, custom glass, Moroccan-style ceramic tile, custom wood vanity, quartz countertop, and large-format floor tile
Finished secondary bathroom with walk-in shower, custom glass, Moroccan-style ceramic tile, custom wood vanity, quartz countertop, and large-format floor tile.

Original Bathroom: Fiberglass Insert, Old Valve, And Moisture Damage

The original bathroom had a builder-grade fiberglass tub/shower insert with an older Delta valve. The overall look was dated, but the bigger issue was performance. During demolition, Big Horn Remodeling found mold on the drywall caused by a failed seal.

That damaged material was removed and mitigated properly before the new shower assembly was rebuilt. This is one reason tub-to-shower conversions should not be treated as surface-only updates.

Hidden condition

Moisture-damaged drywall was removed and mitigated before the new shower assembly was closed back up.

Field verification

Big Horn verified the slab was not post-tensioned, so x-ray scanning was not required for the concrete access work.

The Plan: Convert The Tub To A Walk-In Shower And Rebuild The Bathroom

The project scope became a full secondary bathroom renovation. Big Horn Remodeling removed the fiberglass tub/shower combo, upgraded the shower drainage path, relocated the shower valve, waterproofed the new shower assembly, tiled the shower and bathroom floor, fabricated a custom vanity, installed a quartz top, painted the bathroom with semi-gloss paint, and coordinated custom frameless glass.

The finished layout keeps the bathroom compact but more refined. The pony wall creates separation at the shower without making the room feel closed off. The hidden shampoo niche is placed inside the pony wall, so storage is available without becoming the first thing you see when looking into the shower.

Custom shower details

Glossy tile, pony wall, hidden niche, and frameless glass made the shower feel designed rather than simply replaced.

Whole-room finish

The custom vanity, quartz, floor tile, fixtures, glass, and semi-gloss paint were coordinated as one bathroom remodel.

Permits And Drain Work: More Than A Cosmetic Bathroom Update

Big Horn Remodeling pulled electrical and plumbing permits because the work changed more than finishes. The project converted a tub/shower combo into a walk-in shower, upgraded the drain from the original tub configuration, relocated the shower valve, and required concealed plumbing work.

A tub can hold water while it drains, but a shower needs the drain system to keep up during active use. Big Horn broke a portion of the slab and ran the shower drain upgrade so the finished shower could perform correctly.

Scope area
What Big Horn did
Why it mattered
Demolition
Removed the builder-grade fiberglass tub/shower insert and opened the wet area.
Allowed Big Horn to inspect the framing, drywall condition, drain path, valve location, and waterproofing needs.
Mold mitigation
Removed and mitigated drywall damaged by moisture from a failed old shower seal.
Prevented hidden damaged material from being closed back up behind the new custom shower.
Permits
Pulled electrical and plumbing permits for the hidden-system work.
The project changed more than finish materials, including plumbing and electrical scope.
Drain upgrade
Accessed the slab and upgraded the tub drain path for shower use.
A shower needs drainage that keeps up during active use instead of relying on a tub-style drain configuration.
Slab condition
Verified the slab was not post-tensioned before concrete access work.
Confirmed x-ray scanning was not required for this scope.
Valve relocation
Replaced the old Delta valve with a relocated Kohler shower valve.
The new valve location lets the homeowner turn on the shower before stepping into the water stream.
Waterproofing
Built a shower pan with felt liner turned up about 6 inches and used AquaDefense in wet areas.
Protected the shower assembly before the ceramic tile and glass finish went in.
Water test
Plugged the drain and held water for 24 hours before tile installation.
Confirmed the shower pan and waterproofing before the expensive finish layer was installed.
Tile and glass
Installed Moroccan-style 3x6 ceramic tile, pony wall, hidden niche, floor tile, and custom frameless glass.
Made the compact secondary bathroom feel more custom, open, and intentional.
Vanity and finishes
Installed a custom wood-tone vanity, quartz top, black fixtures, large-format floor tile, and semi-gloss paint.
Added storage, warmth, durability, and a cleaner finished bathroom layout.

For broader permit planning, review Big Horn's remodel permits page before changing plumbing, electrical, or wet-area layouts.

Waterproofing System And 24-Hour Water Test

The shower pan was built with a felt liner that turned up approximately 6 inches at the walls. AquaDefense was used throughout the remaining shower waterproofing areas. Before tile was installed, Big Horn Remodeling performed a water test by plugging the drain and holding water for 24 hours to confirm there were no leaks.

That water test is one of the most important quality-control steps in a shower remodel. Tile and grout are finish materials, not the only waterproofing strategy. The waterproofing needs to be confirmed before the expensive finish layer goes in.

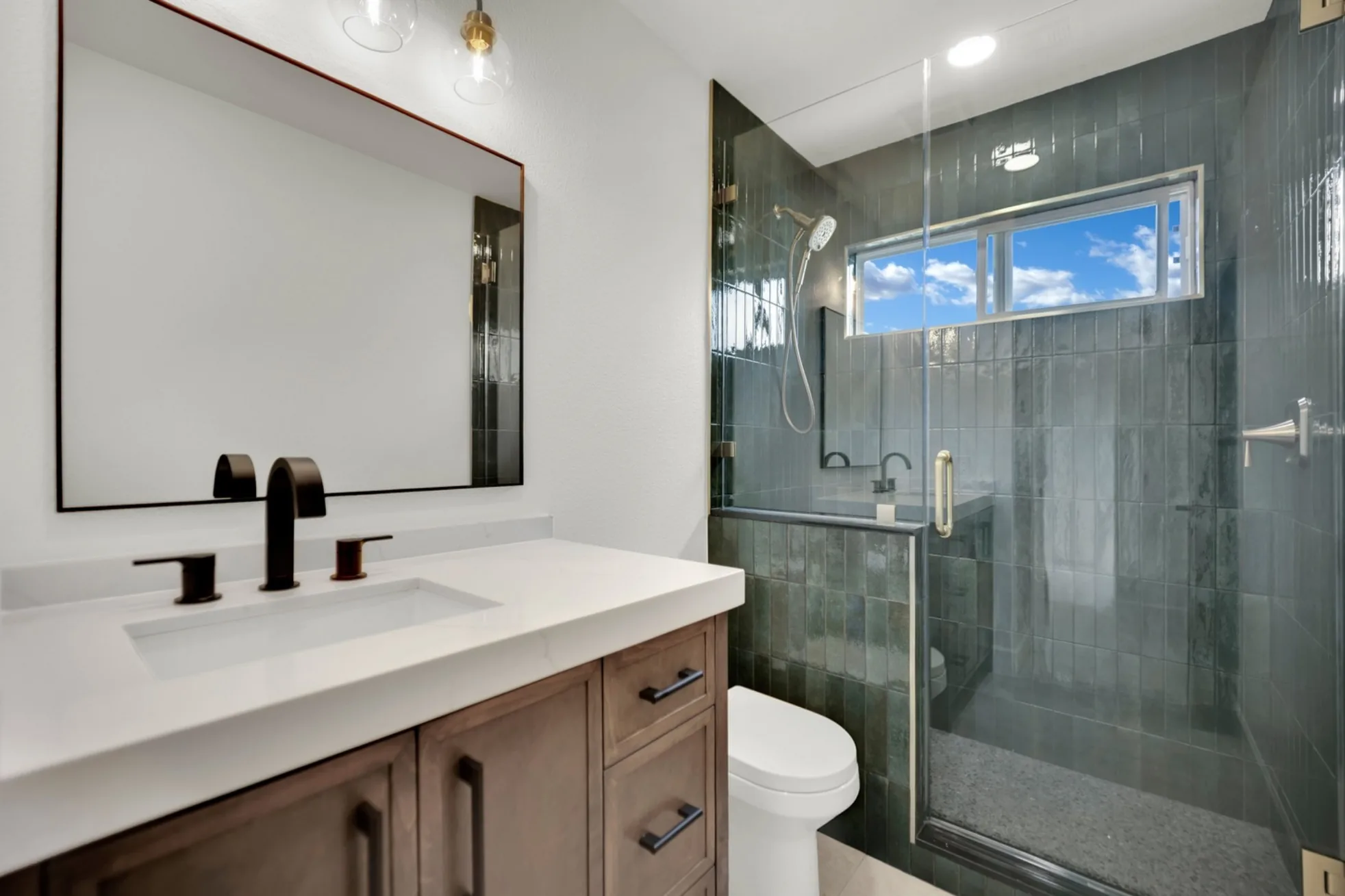

Walk-in shower with glossy Moroccan-style ceramic tile, pony wall, hidden niche, custom glass, and warm metal accents
Walk-in shower with glossy Moroccan-style ceramic tile, pony wall, hidden niche, custom glass, and warm metal accents.

Design Details: Moroccan-Style Tile, Pony Wall, Vanity, Glass, And Paint

The shower wall tile is a 3x6 ceramic tile with intentional variation from piece to piece. The inconsistent surface and glossy finish give the shower a Moroccan/Zellige- inspired look without making the room feel overly busy.

The bathroom was finished with a custom-fabricated vanity and quartz countertop. The warm wood-tone vanity adds storage and contrast against the white walls, black door, black fixtures, and deep green-blue shower tile. Large-format bathroom floor tile keeps the main floor cleaner visually, while semi-gloss paint gives the walls a more practical finish for a humid room.

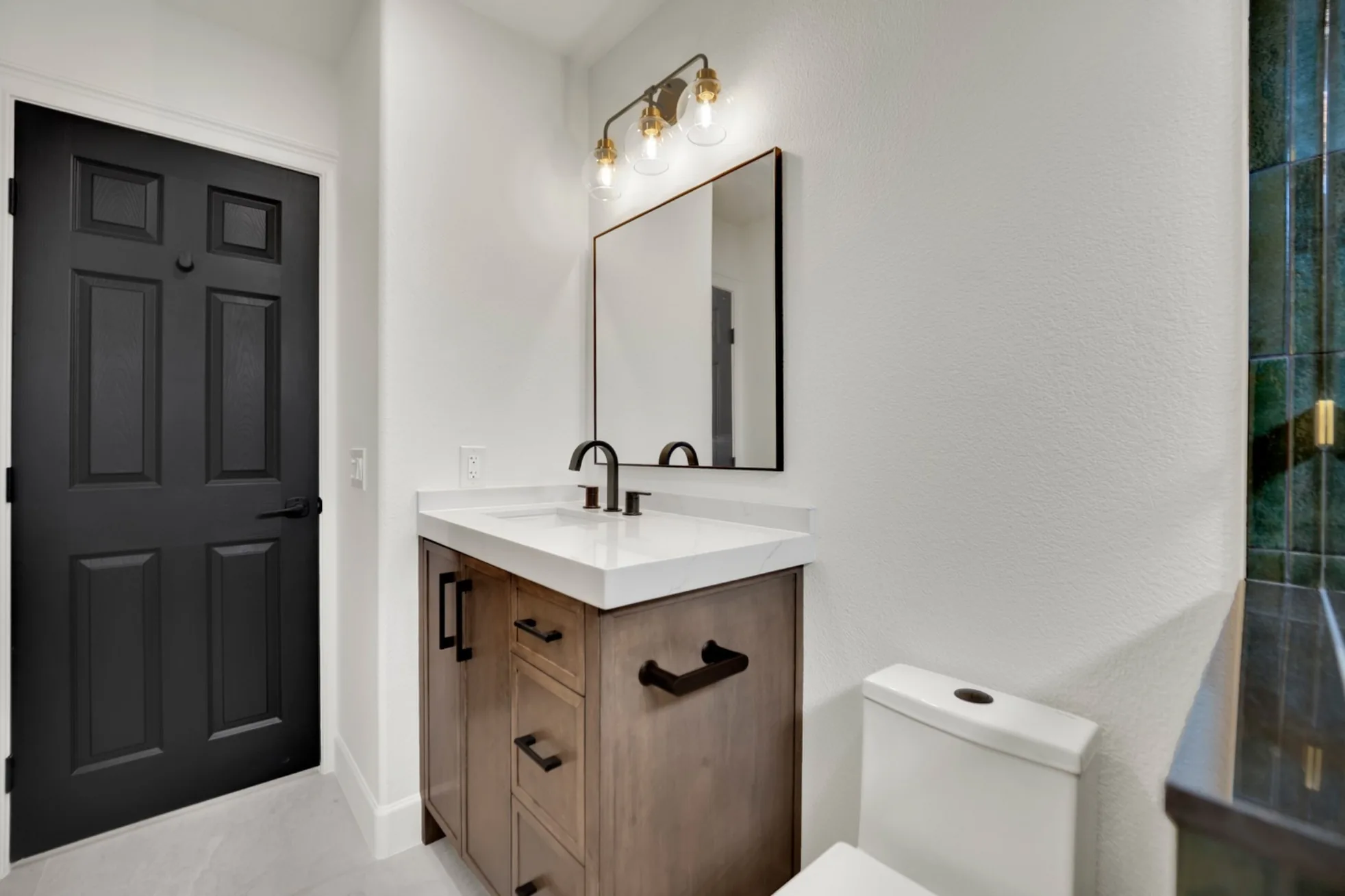

Custom wood bathroom vanity with quartz countertop, black fixtures, rectangular mirror, and semi-gloss painted walls
Custom wood bathroom vanity with quartz countertop, black fixtures, rectangular mirror, and semi-gloss painted walls.

Cost Analysis: Approximate $18,000 Completed Project Investment

This completed secondary bathroom remodel was approximately $18,000. That price reflects the actual completed project, not a fixed menu price for every tub-to-shower conversion. Similar projects can cost more or less depending on slab access, drain routing, permit requirements, tile selection, glass layout, vanity size, fixture selection, waterproofing details, and hidden conditions found after demolition.

Cost category
Approx. allocation
What it covered
Demolition and mitigation
$2,000 - $3,000
Tub/shower insert removal, drywall exposure, mold-damaged material removal, mitigation, protection, and cleanup.
Permits, plumbing, and drain upgrade
$4,000 - $5,000
Electrical and plumbing permit path, slab access, shower drain upgrade, and relocated Kohler valve rough-in.
Waterproofing and water test
$2,500 - $3,500
Felt liner, AquaDefense waterproofing, pony wall and niche details, shower pan preparation, and 24-hour water test.
Tile and floor installation
$3,500 - $4,500
Moroccan-style shower wall tile, large-format bathroom floor tile, layout control, setting materials, and finish work.
Custom vanity, quartz, glass, and finishes
$4,000 - $5,000
Custom vanity fabrication, quartz top, custom frameless glass, fixtures, semi-gloss paint, punch work, and final walkthrough.
Total
Approx. $18,000
Completed project investment.

Timeline: Approx. 3 Weeks Of Active Construction

The active construction timeline was approximately 3 weeks. This timeline describes the field work after the project scope, permits, materials, and glass planning were coordinated. Custom glass and material lead times can affect total calendar time, so the active construction period should not be confused with the full planning-to-closeout window.

1

Preconstruction

Scope review, permit planning, fixture and tile direction, vanity coordination, glass planning, and client expectations.

2

Week 1

Site protection, fiberglass tub/shower demolition, mold-damaged drywall removal and mitigation, slab access, drain upgrade planning, valve relocation rough-in, and permit sequencing.

3

Week 2

Shower pan construction, felt liner installation, AquaDefense waterproofing, 24-hour water test, pony wall and hidden niche detailing, and tile installation.

4

Week 3

Large-format floor tile, custom vanity and quartz top installation, Kohler fixture trim-out, custom glass coordination, semi-gloss paint, punch list, cleanup, and walkthrough.

Finished Result: Builder-Grade Bath Turned Into A Custom Walk-In Shower

The finished secondary bathroom now feels custom, clean, and much more cohesive. The old fiberglass tub/shower combo was replaced with a tiled walk-in shower, frameless glass, a pony wall, hidden niche, and a more thoughtful valve location.

The most important part of the project is what is behind the finished surfaces: permitted plumbing and electrical work, a shower drain upgrade, proper mold-damaged drywall removal, a waterproofed shower assembly, and a 24-hour water test before tile installation.

Project Location Map

This project was completed in the Tule Springs / Centennial Hills area of Northwest Las Vegas. The exact address is withheld for client privacy.

Project completed in the Centennial Hills / Tule Springs area. Exact address withheld for client privacy.

Curbless shower comparison

Compare this scope with Big Horn's curbless walk-in shower conversion case study.

Primary bath example

Review the primary bathroom remodel with marble shower for a larger bathroom-suite example.

Local planning

Use the Centennial Hills remodeling contractor page for broader Northwest Las Vegas planning context.

Bathroom service hub

For pricing ranges, waterproofing, permit planning, and scheduling, start with the bathroom remodel service page.

Planning a tub-to-shower conversion?

Big Horn Remodeling can review your existing bathroom, confirm permit requirements, check drain and valve options, and explain what has to happen behind the tile before your shower is rebuilt.

Frequently Asked Questions

How much did this tub-to-shower conversion cost?
This completed secondary bathroom remodel was approximately $18,000. The cost included the tub-to-shower conversion, drain upgrade, valve relocation, waterproofing, tile, custom vanity, quartz top, permits, custom glass, paint, and finish work.
How long did the bathroom remodel take?
The active construction timeline was approximately 3 weeks after scope, material coordination, and permit planning. Total calendar time can vary depending on permit processing, custom glass lead times, tile availability, and client selections.
Did the tub-to-shower conversion require permits?
Yes. Big Horn Remodeling pulled electrical and plumbing permits because the project changed more than surface finishes. The tub was converted into a walk-in shower, the drain was upgraded for shower use, and the shower valve was relocated.
Why did the drain need to be upgraded?
The original tub/shower combo used a tub-style drain configuration. A tub can hold water while it drains, but a shower needs drainage that keeps up while someone is actively showering. Big Horn Remodeling broke a portion of the slab and upgraded the shower drain path for the new walk-in shower.
Why was the shower valve moved?
The client wanted the shower valve on the opposite side so the shower could be turned on and warmed up before stepping into the water stream. That change made the shower more comfortable to use every day.
What waterproofing system was used?
The shower pan used a felt liner turned up approximately 6 inches at the walls, and AquaDefense was used throughout the remaining wet-area waterproofing. Big Horn Remodeling then performed a 24-hour water test before tile installation.
Was mold found during the remodel?
Yes. Some mold was found on the drywall because the old shower seal was not performing properly. The affected material was removed and mitigated properly before the new shower assembly was built.
Was the slab post-tensioned?
No. Big Horn Remodeling verified that this slab was not post-tensioned, so x-ray scanning was not required before the concrete access work.
What tile was used in the shower?
The shower wall tile was a 3x6 ceramic tile with intentional variation from tile to tile, creating a Moroccan/Zellige-inspired look. The main bathroom floor used larger-format tile to reduce grout lines.
Did the project include custom glass?
Yes. The shower required custom frameless glass with warm gold/brass-style accents, which helped the finished bathroom feel open, bright, and more custom.
Did the project include a custom vanity?
Yes. Big Horn Remodeling fabricated a custom vanity for the bathroom and installed a quartz top, adding storage and warmth to balance the deep shower tile and white walls.
Does Big Horn Remodeling do tub-to-shower conversions in the Centennial Hills and Tule Springs area?
Yes. Big Horn Remodeling handles tub-to-shower conversions, walk-in showers, bathroom remodels, permits, waterproofing, tile, custom vanities, and glass coordination in Centennial Hills, Tule Springs, Skye Canyon, Providence, and surrounding Northwest Las Vegas areas.
