Big Horn Remodeling
Close-up of a wood kitchen island with dark hardware, white perimeter cabinets, and light countertop

How Long Does Kitchen Cabinet Installation Take in Las Vegas?

Cabinet-specific timeline guide for Las Vegas homeowners covering field measurements, cabinet ordering, delivery, room readiness, installation, adjustments, and countertop-template handoff.

Nathan Nehoraoff - Owner of Big Horn Remodeling, Nevada B-2 License #0091383

Nathan Nehoraoff

Owner & Licensed Nevada General Contractor

Published June 25, 20266 min readCabinet Timeline Guide

Short answer: For a standard Las Vegas kitchen, the on-site cabinet installation usually takes about 3-5 working days once the room and cabinets are ready. Small stock-cabinet kitchens may take 2-3 days; large or custom installations may take 5-10 days. Ordering and production are separate: stock may take 1-3 weeks, semi-custom 6-10 weeks, and custom 10-16+ weeks.

This guide explains the cabinet-specific timeline for Las Vegas homeowners, including field measurements, cabinet ordering, delivery, room readiness, kitchen cabinet installation, adjustments, and countertop-template handoff. It does not cover the full kitchen remodel schedule.

This guide is for cabinet-only scope. If your project includes countertops, backsplash, flooring, appliance relocation, plumbing, electrical, permits, or layout changes, use our kitchen remodel timeline guide instead.

Cabinet Installation vs Full Remodel Timeline

Cabinet installation is only one phase of a larger kitchen remodel. Countertops, backsplash, finish plumbing, finish electrical, appliance installation, final inspections, and punch-list work can add time after cabinets are installed.

For the full project sequence, see our kitchen remodel timeline guide.

Cabinet Lead Time vs Installation Time

Cabinet lead time is the time needed to approve, order, build, ship, and check the cabinet package. Cabinet installation time is the time spent setting, leveling, fastening, trimming, and adjusting cabinets on site. Those are separate schedule blocks.

Cabinet stage
Typical time
Done when
Field measure / signoff
3-7 business days
Final dimensions, appliance specs, fillers, panels, finish, hardware, and cabinet drawings are approved.
Order / production
Stock: 1-3 weeks; semi-custom: 6-10 weeks; custom: 10-16+ weeks
Cabinets are complete and released for delivery.
Delivery / QC
1-3 business days
Boxes, doors, panels, trim, fillers, and hardware are checked for damage or missing parts.
Room readiness
1-3 working days
Old cabinets are removed if in scope, utilities are safe, walls and floors are ready, and layout lines are confirmed.
Cabinet installation
Small stock: 2-3 days; standard semi-custom: 3-5 days; large or custom: 5-10 days
Cabinets are level, plumb, fastened, aligned, and set with panels, fillers, trim, and island details.
Adjustments / handoff
1-3 working days
Doors and drawers are adjusted, hardware is installed, punch items are recorded, and the kitchen is ready for countertop template.
Contractor measuring a stainless refrigerator opening in a white kitchen before cabinet ordering
Field measurements confirm refrigerator openings, appliance clearances, wall conditions, and order readiness before installation starts.

Stock, Semi-Custom, and Custom Lead Times

Stock cabinets usually move fastest because sizes and finishes are limited. Semi-custom cabinets need more production time because the package is more specified. Custom cabinets take the longest because drawings, finishes, panels, built-ins, and field details must be coordinated before fabrication.

Cabinet type also affects budget. If you are comparing the schedule with cabinet pricing, use the kitchen cabinet cost guide before approving the order.

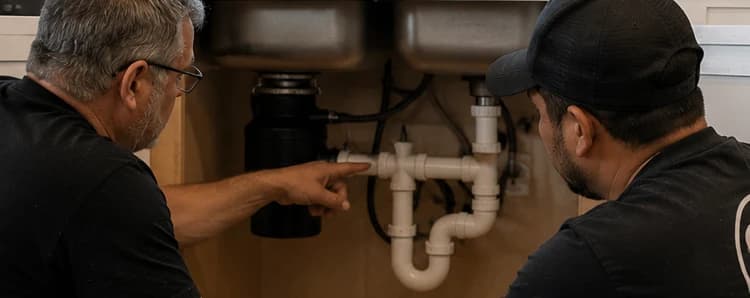

Two contractors reviewing drain and disposal plumbing inside a kitchen sink base cabinet
Sink base plumbing, disposal location, and cabinet openings should be reviewed before cabinet ordering and cabinet installation.

Standard Five-Day Cabinet Installation Sequence

A standard cabinet installation often follows this sequence once the room is ready and the cabinet package is complete. The exact number of days depends on kitchen size, cabinet type, site conditions, panels, trim, island details, and punch-list items.

Day
Typical work
Hold point
Day 1
Confirm layout, establish level reference, and set corner, first base, and first wall cabinets.
Wall or floor variation, unsafe backing, or utility conflicts.
Day 2
Continue base and wall cabinets, tall units, and appliance openings; align cabinet runs.
Missing or damaged boxes, wrong appliance opening, or incorrect cabinet size.
Day 3
Set island cabinets, fillers, panels, toe kicks, and primary trim.
Island utilities, floor anchors, decorative panels, or support details.
Day 4
Install crown, light rail, hardware, door/drawer alignment, and field modifications.
Stacked trim, heavy scribing, or late owner changes.
Day 5
Complete final adjustment, punch list, protection, and countertop-template readiness.
Replacement parts, unresolved punch items, or template conditions not met.

Want a realistic cabinet timeline?

Big Horn Remodeling can review field measurements, cabinet lead time, delivery, room readiness, and countertop-template handoff before installation starts.

Call or text

(702) 799-9902

What Must Be Ready Before Cabinet Installation

Cabinet installation is smoother when the installer is not discovering layout, delivery, utility, or wall problems on the first day. These items should be resolved before the cabinet crew starts.

  • Final field measurements and cabinet drawings are approved.
  • Appliance model numbers, sink specs, faucet specs, and hood requirements are confirmed.
  • Boxes, doors, drawers, panels, fillers, trim, hardware, and accessories have been delivered and checked.
  • Old cabinets are removed if that is part of the cabinet scope.
  • Walls, floors, corners, backing, and appliance openings are ready for cabinet layout lines.
  • Utility conflicts that affect cabinet placement have been identified before install day.

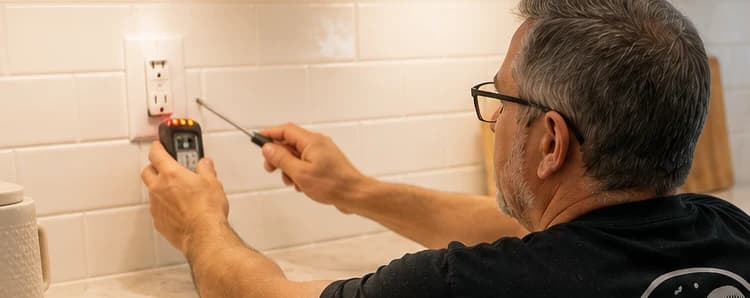

Contractor checking an electrical outlet in a white tile kitchen backsplash
Outlet placement and utility conflicts should be identified before cabinet installation blocks access.

What Delays Cabinet Installation

Most cabinet delays come from late selections, incomplete deliveries, damaged parts, or field conditions that do not match the approved cabinet layout.

Delay
Why it matters
Cabinet drawings or appliance specs are not approved.
Openings, panels, fillers, and clearances cannot be trusted until specs are locked.
Production backlog or finish rework.
The cabinet package is not ready to ship or needs correction before delivery.
Freight damage or missing parts.
Missing boxes, doors, panels, fillers, or trim can stop installation and template readiness.
Walls or floors are out of plumb or level.
The installer may need shimming, scribing, backing, or field modification before cabinets can be set correctly.
Utility or ventilation conflicts.
Unexpected plumbing, electrical, gas, or hood-route conflicts can delay cabinet placement.
Late island, panel, crown, hardware, or organizer changes.
Finish parts and accessories affect layout, installation, adjustment, and punch-list work.
Countertop template is postponed.
Cabinet punch items must be resolved before base cabinets and island cabinets can be measured accurately.

Countertop Template Handoff

Base cabinets and island cabinets usually need to be installed, level, secure, aligned, and finished enough for accurate countertop measurement. Countertop fabrication happens after cabinet installation, but it is not cabinet-installation time.

REALPROJECTPHOTO
Blue base cabinets with beverage refrigerator, white countertop, and blue tile backsplash
Base cabinets, appliance openings, support details, and finished panels need to be ready before countertop templating.

If the project includes countertop fabrication, backsplash, finish plumbing, finish electrical, appliances, and final inspections, review the kitchen remodel timeline guide for the larger project schedule.

Big Horn's Timeline Recommendation

Big Horn Remodeling plans cabinet installation around field verification before ordering. The fastest reliable cabinet project is not the one that starts demolition first. It is the one with approved measurements, appliance specs, complete cabinet delivery, room readiness, and a clear countertop-template handoff.

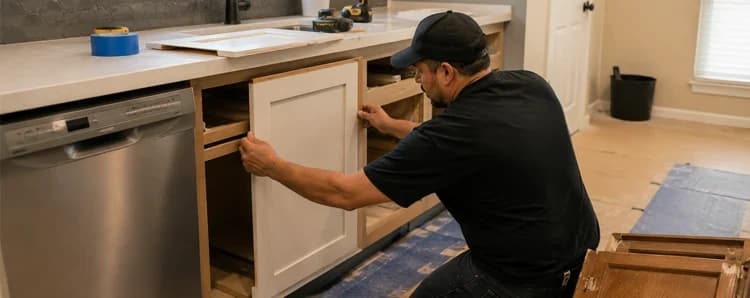

Cabinet installer fitting a white cabinet door on a lower kitchen cabinet
Final cabinet installation work can include door fitting, leveling, alignment, hardware adjustments, panels, trim, and punch-list details.
REALPROJECTPHOTO
Completed kitchen with dark base cabinets, white slab backsplash, gas range, white upper cabinets, and light stone counters
Completed kitchen cabinet installation with dark lower cabinets, slab backsplash, range wall, stone counters, and finish hardware.

Want a realistic cabinet timeline before demolition starts?

Big Horn Remodeling can review field measurements, appliance specs, cabinet lead time, delivery, room readiness, and countertop-template handoff before cabinets are installed. Call or text (702) 799-9902.

Frequently Asked Questions

How many days does it take to install kitchen cabinets?
For a standard Las Vegas kitchen, on-site cabinet installation usually takes about 3-5 working days once the room and cabinets are ready. Small stock-cabinet kitchens may take 2-3 days, while large or custom installations may take 5-10 days.
Is cabinet lead time included in installation time?
No. Cabinet lead time is separate from on-site installation time. Stock cabinets may take 1-3 weeks, semi-custom cabinets may take 6-10 weeks, and custom cabinets may take 10-16+ weeks before the installation crew can begin.
What must be finished before cabinet installation starts?
Final field measurements, cabinet drawings, appliance model numbers, sink and faucet specs, cabinet delivery, quality-control checks, room readiness, safe utilities, wall conditions, floor conditions, and layout lines should be confirmed before cabinet installation starts.
When can countertops be measured after cabinets are installed?
Countertops can usually be measured after base cabinets and island cabinets are installed, level, secure, aligned, and finished enough for accurate template measurements. Missing panels, support issues, or unresolved cabinet punch items can postpone templating.
What can delay a cabinet installation?
Common cabinet installation delays include unapproved cabinet drawings, late appliance specs, production backlog, finish rework, freight damage, missing boxes, missing panels, out-of-level floors, uneven walls, utility conflicts, late island changes, and postponed countertop templating.
Can appliances be installed before countertops?
Some appliance specs and rough positioning must be confirmed before cabinets are ordered, but final appliance installation usually depends on cabinets, countertops, openings, clearances, and the broader project sequence. The exact timing should be coordinated before installation starts.
